Concrete swimming pool construction: shotcrete or formwork?
Shotcrete or double-sided formwork for the shell, C30/37 concrete, a water/cement ratio below 0.45 and the waterproofing details of a concrete pool.
Project Manager · Mechatronics Engineer · Çilek Havuz
- Published
- Updated
- Reading
- 10 min read
- Category
- Pool Construction
Shotcrete or double-sided formwork for the shell, C30/37 concrete, a water/cement ratio below 0.45 and the waterproofing details of a concrete pool.

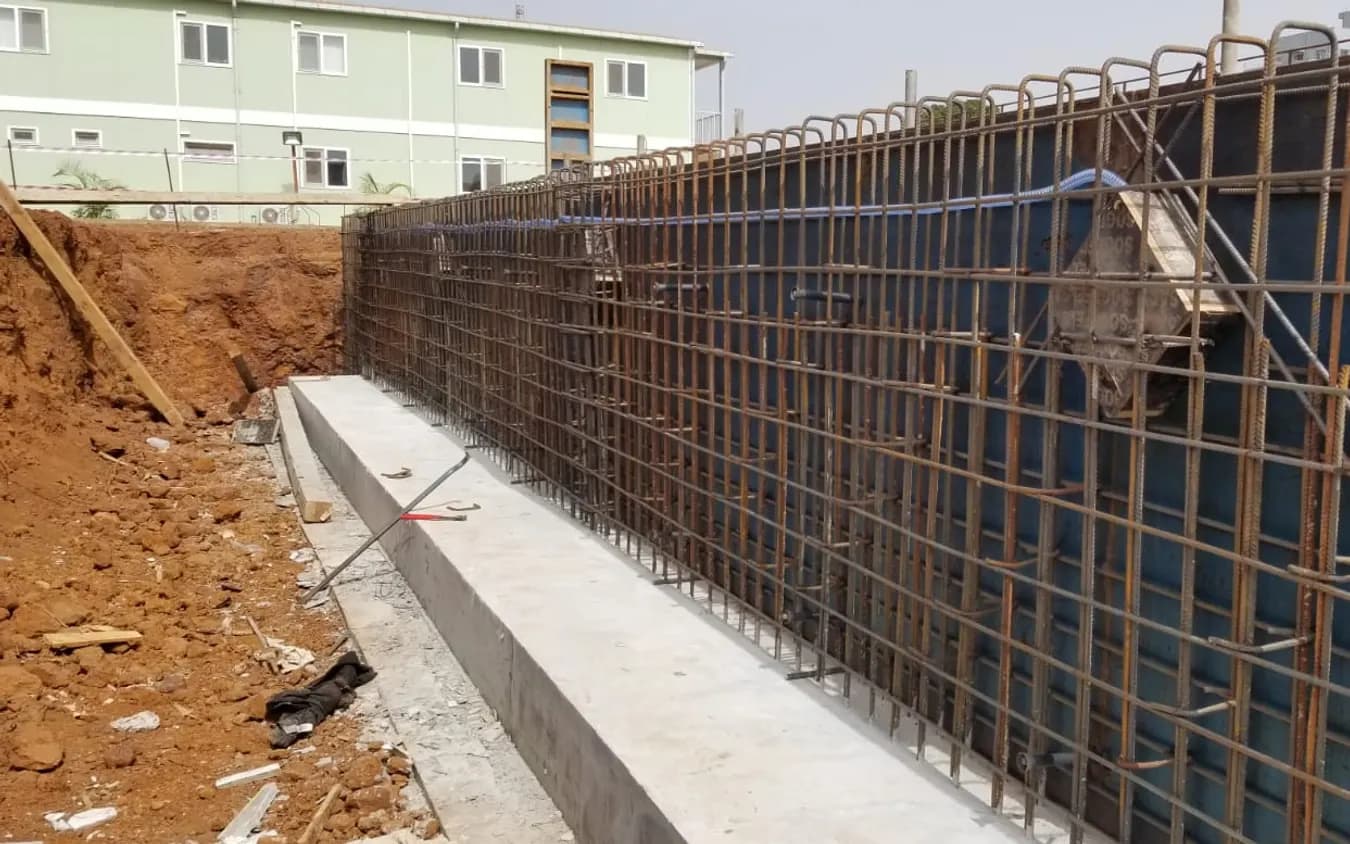

The concrete swimming pool construction technique is the production of the water-bearing shell as a single-piece (monolithic) vessel of steel reinforcement and concrete.
The shell is built by two methods: shotcrete, where the concrete is carried by hose and sprayed onto the surface with compressed air, and formed casting, where the concrete is poured between two-sided formwork and compacted with a vibrator. Both methods serve the same goal: a box that does not crack, does not leak and carries the load of the ground.
This article is not a comparison of prefabricated and concrete pools, nor a cost article. The subject is how the concrete pool shell is produced, what the concrete class and the water/cement ratio mean, and by which rule the reinforcement and waterproofing details are written. The sequence of the pool construction process is covered in a separate article on the stages.
Shotcrete is concrete or mortar conveyed through a hose and pneumatically projected at high velocity onto a surface; the technique was developed by Carl Akeley and first used in 1907.
It has two sub-methods: dry mix (gunite) and wet mix. In the dry mix the dry components are conveyed through the hose and the water is added at the nozzle by the operator; in the wet mix ready-mixed concrete is pumped and compressed air is supplied at the nozzle. The wet mix produces less rebound, waste and dust than the dry mix and places a larger volume in a shorter time.
| Criterion | Shotcrete (wet mix) | Formed casting (double-sided formwork) |
|---|---|---|
| Shell shape | Free form; curved walls and stepped floors are easy | Vertical and flat surfaces; special formwork for curves |
| Formwork need | One face only (excavation slope or back-face formwork) | Two faces; form ties and waterstop plugs required |
| Cold joint | Floor and walls can be sprayed on the same day; few joints | Floor and walls cast separately; the floor-wall joint is sealed with a waterstop |
| Compaction | Compacts by spray velocity; depends on nozzle skill | Compacts by vibrator; measurable and repeatable |
| Surface | Finished with a trowel; render coat required | Formwork surface is flat; thinner render coat |
| Quality control | Cores from a test panel; nozzle distance and angle are checked | Cube or cylinder samples; slump and curing record |
| Suitable project | Villa pools, free-form pools and pools of varying depth | Olympic, semi-Olympic and square-cornered commercial pools |
Shotcrete shows high compressive strength, good durability, watertightness and frost resistance, and swimming pool construction is one of its classic applications. The advantage of formed casting is measurability: the concrete is sampled as it arrives from the batching plant, and the vibration time goes into the record. In commercial pools and square-cornered geometry we prefer formed casting; in free-form villa pools we prefer wet-mix shotcrete.
The concrete class is written with two numbers: C30/37 is concrete whose 28-day characteristic compressive strength is 30 N/mm² on a cylinder sample and 37 N/mm² on a cube sample.
28-day compressive strength is the measure of concrete quality used in specifications; concrete is strong in compression but markedly weak in tension; that is why the shell carries steel reinforcement in the tension zones. For a pool shell C30/37 is the lower limit; on plots in contact with salt water or with a high water table it goes up to C35/45.
The water/cement ratio is the mass of water in the mix divided by the mass of cement. Full hydration needs about 0.35 mass of water per cement; typical ratios lie between 0.40 and 0.60, and mixes above 0.60 give porous and weak concrete. Excess water increases porosity and permeability, accelerates carbonation and reinforcement corrosion, and multiplies shrinkage cracks. Because watertightness is more decisive than strength in a pool shell, our specification keeps the water/cement ratio below 0.45; workability is obtained with a plasticiser admixture, not with water.
Concrete specification items for the pool shell
- Concrete class at least C30/37; C35/45 in salt water and high water table.
- Water/cement ratio at most 0.45; slump adjusted with plasticiser, no water added to the mixer truck on site.
- Crystalline or hydrophobic waterproofing admixture; admixture quantity written on the plant delivery note.
- Cube or cylinder samples on every casting day; test panel and cores for shotcrete.
- Curing: the surface is kept moist for at least seven days; night casting and wet covering when the air temperature is above 30 °C.
- Reinforcement cover at least 40 mm on surfaces in contact with water; 50 mm under seawater exposure.
Put plainly: all concrete structures crack to some extent, due to shrinkage and tension.
The task of pool technique is to keep the crack thin and closed enough not to pass water, rather than to eliminate it. The tool for this is crack control reinforcement added on top of the load-bearing reinforcement set by calculation: closely spaced bars in both faces and both directions produce many hairline cracks instead of one wide crack, and a hairline crack closes itself with the crystalline admixture.
Double-layer reinforcement is standard in a pool shell: the floor and walls are reinforced with separate meshes on the inner and outer faces, and lapped corner bars are used at corners and at the floor-wall junction. Extra reinforcement is placed at changes of section such as steps, benches and depth transitions; cracks start most often where the section narrows. The surround of parts that pierce the shell, such as skimmers, inlets and the main drain, is wrapped with diagonal bars running out from the corners of the opening.
In a concrete pool shell, water escapes at three places: the cold joint, the form tie hole and the pipe penetration through the shell.
The cold joint is the line of junction between the floor concrete and the wall concrete; when the two pours are made on different days, no monolithic bond forms between them. The remedy is a waterstop embedded in the floor concrete and running into the wall concrete; PVC waterstop or water-swelling bentonite strip is used. In shotcrete, making the floor and the wall on the same day removes this joint.
Form ties are the rods that connect the two faces of double-sided formwork; when removed, they leave holes in the shell. In pool formwork, ties with waterstop plugs are used, or the holes are sealed from inside out with epoxy mortar. At pipe penetrations a sleeve and a waterstop flange are used; the pipe is not embedded directly in the concrete. On top of these three details come a waterproofing admixture inside the shell and a cement-based flexible waterproofing layer on top of the shell.
Curing keeps the moisture of the concrete during the first days so that hydration continues. Concrete poured at a 0.45 ratio without excess water cannot complete hydration if its surface dries out, and shrinkage cracks open on the surface; on a pool site the shell is kept wet for seven days and covered with wet sheeting in heat above 30 °C. The water-holding test is done after curing and before finishing: the pool is filled and the level loss is monitored for 48 hours with evaporation deducted.
Glossary
- Shotcrete
- Concrete conveyed through a hose and projected onto a surface at high velocity with compressed air; there are two methods, dry mix (gunite) and wet mix.
- Gunite
- The old registered name of dry-mix shotcrete; the method in which the water is added at the nozzle. As of 1951, shotcrete is the generic term covering both methods.
- C30/37
- Concrete class: 28-day characteristic compressive strength of 30 N/mm² on a cylinder and 37 N/mm² on a cube.
- Water/cement ratio
- The ratio of the mass of water in the mix to the mass of cement; as it falls, strength and watertightness rise, and workability is obtained with a plasticiser.
- Cold joint
- The line where two concrete masses poured at different times meet without forming a monolithic bond; sealed with a waterstop.
- Cover
- The thickness of concrete between the reinforcement surface and the concrete surface; at least 40 mm on surfaces in contact with water.
- Rebound
- Concrete that does not adhere to the surface during spraying and falls away; it is greater in the dry mix than in the wet mix and does not become part of the shell.
Pour-day checklist
- 01Are the class (C30/37), admixture and water/cement ratio written on the concrete delivery note; no water to be added on site.
- 02Is the reinforcement double-layer, are the cover spacers in place, is the reinforcement around corners and openings tied.
- 03Is there a waterstop in the floor-wall joint and are there waterstop plugs on the form ties.
- 04Have the pipe penetrations been placed with sleeve and flange; no pipe to be embedded directly in the concrete.
- 05For shotcrete, is the test panel ready; are the nozzle distance and angle being watched by the crew foreman.
- 06Curing plan: seven days wet, night casting and wet covering in heat.
Shotcrete was developed by Carl Akeley in 1907; the dry-mix method was registered under the name gunite, and by 1951 shotcrete had become the official general term covering both methods.
